Arunachal Pradesh

Arunachal Pradesh Groups Ask MoEF to Cancel Illegal Public Hearing of Lower Siang

22nd January 22, 2014

Dr. V. Rajgopalan

Secretary,

Ministry of Environment and Forests,

New Delhi.

Sub: 2700 MW Lower Siang project – Cancel Illegal Public Hearings proposed for January 31st 2014.

Dear Dr. Rajgopalan,

We write to you on behalf of the Forum for Siang Dialogue (FSD), Siang Peoples’ Forum (SPF) Sirit-Siyom Banggo Dam Affected peoples’ Forum (SSBDAPF), Siang Bachao Andolan (SBF), Nyiko Bachao  Forum (NBF) to seek cancellation of the Three public hearings proposed to be held for the 2700 MW Lower Siang hydroelectric project in the East Siang, West Siang and Upper Siang districts of Arunachal Pradesh  on January 31, 2014.

Through a notification dated 30th December 2013 published in the Arunachal Times dated 31st December 2013 the Arunachal Pradesh State Pollution Control Board (APSPCB) has announced the conduct of public hearings for the 2700 MW Lower Siang project in three districts of Arunachal Pradesh. A scanned copy of the notice is attached for reference (Annexure 1).

There are a number of legal reasons due to which the public hearings need to be cancelled, here are a few of them:

1)      Public hearing on the same day and time in the West Siang, East Siang and Upper Siang districts of Arunachal Pradesh

There are a number of local persons/clans/local communities who have land directly affected by the Lower Siang project cross-cutting the district boundaries. Such persons/clans/local communities will not be able to exercise their legal right to participate in all the public hearings in the districts where their ancestral lands are affected, since they are being held on the same day, at the same time. This is a gross violation of the letter and spirit of the EIA notification 2006 as well as the article 14 of Right to equality and article 19, the freedom of Speech under the Constitution of India.

It is crucial that the public hearings are held in the three districts with sufficient days in between to enable the affected persons to participate in the public hearings wherever their ancestral lands are affected.

It cannot be argued that they should put their viewpoints in one of the public hearings in one of the districts. It is their legal right to participate in the public hearings wherever their lands are affected. This is a clear ground for cancellation of the public hearings and re-announcement  by keeping sufficient days in between hearings being held in different districts.

2)      Location of public hearing venue more than 100 km. away from 11 villages

The public hearing venue fixed for the East Siang district is Pasighat, the district headquarters, in the downstream-affected area of the project. While the APSPCB is welcome to organise a separate public hearing for the downstream-affected area, this is an extremely inconvenient location for the upstream-affected villagers in the East Siang district who are directly affected. And Pasighat town is nowhere listed as an affected village/area/circle in the EIA,EMP and Social Impact Assessment report of the Project Proponent. (Attached is the list of the affected villages as prepared by WAPCOS for the project.

The Public Hearing for Upper Siang District is also fixed at Katan which is 40 Kms away from Geku villages, which is encompassing the majority of the villages to be affected by the dam and above all there are not even a single Govt/Public or Private transport plying/ operating there. And the only village which is going to be completely submerged happens to be Pongging village under Upper Siang district, and the people have to walk on foot covering a distance of 17 kilometers to reach Katan as there is no Public/Private/Govt Transport system plying there.

Out of the 25 villages directly affected in East Siang district, at least 11 are more than 100 kms. away from the public hearing venue! In fact Riga village, one of the severely affected village under East Siang District is 172 km. away from Pasighat. A further nine villages are 60 – 100 km. away. Please note that 6 (Six) villages have to walk for up to 12 km. even before reaching the motor able road.

It is clear that the public hearing venue in East Siang district has been decided in order to disallow active participation of directly affected villages. This is completely unacceptable as per the letter and spirit of the EIA notification 2006 and various court orders/judgements on the need for proximity of the public hearing venue to the affected area. Public hearings cannot be located as per convenience of government officials who do not want to travel to affected areas and stay in the district headquarters. This another strong ground why the public hearings announced for 31st January 2014 have to be cancelled immediately.

And Chapter II U/s 5 of The Right to Fair Compensation and Transparent Land Acquisition Relief and Resettlement Act 2013 also clearly states that Public Hearing should be held in the Affected area and not otherwise.

3)      Siang river basin cumulative impact assessment study is not complete and placed in the public domain at designated places before public hearing

Section 9.4 of Form I of the EIA notification requires that cumulative impacts of a project are examined during the EC process. Further the Ministry of Environment and Forests (MoEF) has issued an OM dated 28th May 2013 stating that it will consider hydropower projects based on cumulative impact assessment and carrying capacity studies. The OM is attached as Annexure 2.

The OM states that:

“While  the first project in a basin could come up without insisting on cumulative study for all subsequent hydro-power projects in the basin it should be incumbent on the developer’ of the second/other project(s) to incorporate all possible and potential impact of other project(s) in the basin to get a cumulative impact assessment done.”

An important aspect of Appraisal done by EAC/MoEF is detailed scrutiny done of all documents including public consultation proceedings. As per the EIA notification 2006 (section 9.4 of Form I) and the MoEF’s OM dated 28th May 2013 if cumulative impacts studies have to be the basis for decision-making, then such studies have to placed in the public domain at designated places 30 days prior to the public hearing.

However, the Siang river basin cumulative impact assessment is neither complete nor placed in the public domain at the designated places prior to the public hearing. Please note that this study currently underway is looking at all projects in the Siang river basin (Siang and its tributaries).

Although we disagree with the logic that the first project could come up without ‘insisting’ on a cumulative impact assessment study (since that project could be the most ecologically and socially destructive), in this case Lower Siang is NOT even the first project in the river basin for which either a public hearing is being held or being considered for environmental clearance. A number of public hearings have been held for other projects in Siang river basin and projects have also been already considered for Appraisal by EAC/MoEF. In fact 1000 MW Siyom and 700 MW Tato II project in the Siang river basin have already received final environmental clearance from the MoEF.

By no stretch of imagination is the 2700 MW Lower Siang project the first project being considered in the Siang river basin. Therefore as per the MoEF’s own OM dated 28th May 2013, Siang river basin cumulative impact assessment will first have to be completed. Public hearing should only be held after this is completed and these reports are placed in the public domain at least 30 days before the hearing.

Keeping all this in mind we strongly urge the MoEF to direct the APSPCB to cancel the Illegally notified public hearings proposed for the 2700 MW Lower Siang project on 31st January 2014.

Thanking you,

Sincerely,

Vijay Taram  Oyar Gao   Tayek Mize  Tasong Mibang    Takar Komut   Kento Jini  Reken Ingo

Forum for Siang Dialogue, Siang Peoples’ Forum, Sirit Siyom Banggo Dam Affected Peoples’ Forum, Siang Bachao Andolan, Nyiko Bachao Forum

Cc:

1) EAC on River Valley & Hydroelectric projects

2) Chairperson, Arunachal Pradesh State Pollution Control Board

3) Member Secretary, Arunachal Pradesh State Pollution Control Board

Arunachal Pradesh

Letter to APSPCB – Non-availability of Complete EIA-EMP Report of Lower Siang HEP is a Violation of statutory Norms

21st January 2014

To

Chairman and Member Secretary,

Arunachal Pradesh State Pollution Control Board

Paryavaran Bhawan, Yupia Road

Pappu Hills, Naharlagun

E-mail id – arunachalspcb@gmail.com

Sub: Lower Siang HEP (2700 MW) EIA-EMP Report not fully available on APSPCB website; many links not working; Public hearing will be illegal without full EIA-EMP in public domain

Respected Sir,

This is regarding the EIA-EMP report of Lower Siang HEP (2700 MW) uploaded on APSPCB website. The public hearing for the Lower Siang HEP is schedule to be held on 31st January 2014.

As per the EIA notification of 2006 the full and complete EIA and EMP report should be made available on State Pollution Control Board website, in this case your website at least 30 days in advance of public hearing date as this is necessary not only for the affected people but also for wider consultations for concerned individuals and groups, as required under the EIA Notification. However, full EIA-EMP are not available on your website, with at least three chapters of EIA, one chapter of EMP and several annexures not opening, even ten days before the public hearing date.

It is very surprising and confusing to most people to see that the reports have been uploaded in 145 parts totaling 320 MB file size. These documents should have been uploaded as five reports as done for EIA-EMP report of several other projects. However, we have gone through all the files available on APSPCB website and based on perusal of these files, we find that crucial parts of the statutorily required documents are not available on APSPCB website. The list of missing chapters and annexures with the name of the report is given below. A screenshot of the links to these chapters are also attached and annexure as mentioned below.

No Chapter/Figure Report Status Attached
1 Chapter 2 – CONCEPT & METHODOLOGY EIA Failed to upload Annexure 1
2 Chapter 10 – AQUATIC ECOLOGY FISH & FISHERIES EIA An incomplete, possibly irrelevant table on a 1-page Annexure 2
3 Chapter 12 – CONSTRUCTION METHODOLOGY EIA Failed to upload Annexure 3
4 Chapter 10 –  REHABILITATION & RESETTLEMENT PLAN EMP Failed to upload Annexure 4
5 Fig 3.3 – Gradient profile of Siang river including its major and minor tributaries of the Siang river catchment EIA Not uploaded
6 Fig 3.4 – Gradient profile of the Siang river with its main tributaries in the Siang river catchment area EIA Not uploaded
7 Fig 7.3 – Land use/ land cover map of the submergence area of the proposed Lower Siang H.E. project EIA Failed to upload Annexure 5
8 Fig. 2.3 – Drainage map of the free-draining catchment area of the proposed Lower Siang H.E. project EMP Not uploaded
9 Fig 7.3 & 7.4 – Cross-section at the proposed dumping site EMP Incomplete, failed to upload Annexure 6

We therefore request you to upload these chapters immediately and also upload smaller size single documents of each report for the perusal of the local people and all concerned. In the meanwhile, since non availability of full EIA-EMP on pollution control website a month before the public hearing is a statutory violation, we request you to cancel the public hearing now slated for Jan 31st, 2014 as holding a public hearing without full EIA-EMP on the APSPCB website a month before the PH will not be legally tenable.

Thanking you, we will look for your early response,

Yours Sincerely

Parag Jyoti Saikia

South Asia Network on Dams, Rivers & People (SANDRP), 86-D, AD Block, Shalimar Bagh, Delhi – 110 088

Tel: 91-11- 2748 4654/55; https://sandrp.wordpress.com/, https://sandrp.in/

Arunachal Pradesh

EIA-EMP of Kalai II Hydropower Project Doesn’t Comply with its Terms of Reference

Kalai II HEP – Status of compliance with TOR in EIA and EMP:

Serious non compliance of EIA-EMP: EIA-EMP must go back to consultants WAPCOS

Public hearing based on such EIA-EMP will not be legally valid

The EIA EMP reports of the proposed 1200 MW Kalai II HEP in Lohit basin in Anjaw district in Arunachal Pradesh has been put up on the Arunachal Pradesh Pollution Control Board in advance of the public hearing slated for January 18, 2014. The EIA-EMP report is supposed to comply with the Terms of Reference (TOR) for the EIA-EMP given by the EAC and MoEF, this is statutory requirement as per the EIA notification of Sept 2006. We have just checked this compliance and find that the EIA and EMP reports have not fulfilled a very large number of the TOR (Terms of Reference) that the project was to cover in EIA-EMP as per the TOR clearance given for the project on 9.12.2009. Such EIA-EMP will clearly not be acceptable even from statutory and legal point of view and cannot be basis for a public hearing. Hence Arunachal Pradesh State Pollution Control Board (APSPCB) and MoEF should immediately cancel the public hearing and ask the EIA-EMP consultants to comply first with the TOR.

A letter has been sent to APSPCB pointing out the violation of norms in organizing the public hearing and asking them to cancel the public hearing. This letter is available at “Letter to APSPCB – Public Hearing for Kalai-II HEP to be held Violating the Norms”. A detailed critique of the EIA-EMP report of Kalai II project is also available at “Critique of Kalai II HEP’s Environment Impact Assessment (EIA) Study and Environment Management Plan

Invalid extension since EIA-EMP does not comply with the TOR Here it may be added that as per minutes of 70th EAC meeting dated Dec 10-11, 2013, “In the mean while, MOEF issued an Office Memorandum dated 22-Mar-10 which stipulates that the proposals which were granted TORs prior to the issue of this OM, the EIA / EMP reports should be submitted after public consultation no later than four years from the date of the grant of the TORs with primary data not older than three years. Thus the TOR issued to the project on 9th December 2009 is valid up to 8th December 2013”. By this norm, the Kalai II TOR clearance should have lapsed on Dec 8, 2013. However, EAC decided to give an extension to TOR for this project, since the project developer claimed, as noted in EAC minutes, “With the completion of all the studies, the draft EIA/EMP report for 1200MW Kalai-II HEP was prepared and submitted by the developer to Arunachal Pradesh State Pollution Control Board (APSPCB) vide letter dated 31st July 2013…”. However, this assumes that the EIA-EMP submitted complies with the TOR given by MoEF. But this analysis shows that there is serious non compliance of the EIA-EMP with the TOR and hence submission of such fundamentally inadequate EIA-EMP cannot be a valid reason for providing TOR extension beyong legally stipulated period.

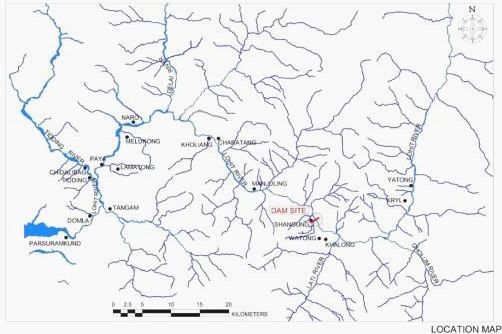

Location of Kalai II HEP. Source: EIA report
Location of Kalai II HEP. Source: EIA report

A list of TOR noncompliancein the EIA-EMP is given below.

Noncompliance in EIA Report:

Geological and Geophysical Aspects

  1. Regional Geology and structure of the catchment – some details only about has been mentioned in the EIA, the latter is not available
  2. Seismicity , tectonics and history of past earthquakes in the area – the EIA only mentioned about seismicity, the latter two has been completely ignored
  3. Critical review of the geological features around the project area – not available
  4. Impact of project on geological environment – not available
  5. Justification for location & execution of the project in relation to structural components (Dam height) – not available

Hydrology

  1. Graph of 10 – daily discharge before and after the project at the dam site immediately below the dam should be provided i n the EIA study – Not available
  2. The TOR mentioned “An elementary stream gauging station should be established at a suitable location downstream to the Dam site of the project” and “Installation of two Rainfall Gauge Stations at upstream of dam site” but none of these has been complied with.

Surprisingly the EIA also mentioned “No gauge and discharge (G&D) data is available at the Kalai-II project site or in the neighborhood.”

Biological resources

1)   “Cropping and horticulture pattern and practices in the study area” – no mention of this in the EIA

2)   Regarding identification of rare and endangered flora and fauna the EIA report mentioned only one “During the study in various seasons in Kalai-II HE project area, following IUCN Red List of threatened plant, Lagerstroemia minuticarpa falls under endangered category. Rest of the species are common in Arunachal Pradesh. However, this species though observed in the study area but not found in the land to be acquired for the project.” (section 8.7 page 8 -22) This is a strange claim that the species is observed in the study area but not found in the land for the project.

3) Fish and Fisheries

a)   The 5 location of study of Fish migrations & Breeding grounds was not done

b)   Impact of Barrage building on fish migration and habitat degradation was not studied

c)   Overall ecological impact upto 10 Km d/ s from the confluence of the TRT with the river or reach of the river in India have not been not studied. The impact of untreated and waste water into the river was not studied and no alternatives explored.

4)                  In the part of impact prediction, impacts on flora and fauna due to changed water quality has not been assessed

Socio Economic aspects In terms of Socio-economic aspects the following should have been included in the EIA report.

· Land details*

· Demographic profile

· Ethnographic Profile

· Economic structure

· Development profile

· Agricultural practices

· Cultural and aesthetics sites

· Infrastructure facilities: education, health and hygiene, communication network, etc.

· Impact on socio- cultural and ethnographic aspects due to Construction of Barrage

But the EIA does not do several of these profiles and limits itself to – Demographic profile, Educational levels, Occupational Profile, Land holding pattern, Assets owned and Livestock and other socio-economic parameters etc.

In page 11- 8 EIA report says “Impacts on cultural, archeological and religious properties Monuments of cultural/ religious/ historical/ archaeological importance are not reported in the project area. Thus, no impacts on such structures is envisaged.” However, the EIA should have looked into the impact of project on places of cultural, religious importance for the  local communities.

Impacts related to Land The EIA ignores what has been suggested in terms of impact prediction for land. The EIA completely ignores –

a) Changes in land use and drainage pattern

b) Changes in land quality including effects of waste disposal

c) River bank and their stability

d) Impact due to submergence

However, in page no 10-23 in the section “Impact of Impoundment on Landuse” the EIA mentions: “The construction of the dam would form the reservoir which will submerge about 640 ha of area in upstream. The area witnessed jhum/shift cultivation practiced by local inhabitants. Submergence of the area would not impact much on the prevailing land use pattern.” This is a false and misleading statement since in the hilly areas of Arunachal Pradesh, shifting cultivation is the main process of cultivation and submergence of such a large area is sure to have impacts on land environment.

TOR Noncompliance in Environment Management Plan:

Under Catchment Area Treatment Plan, the TOR letter had asked the project proponent to prepare 5 thematic maps v i z . Slope map, Drainage map, soil map, Land use/ Land cover Map, Aspect map. Basing on these maps an Erosion Intensity map should have been prepared. But the EMP only has two maps Slope map and Land use Map. No Erosion Intensity map was prepared.

Under Compensatory Afforestation Plan it was mentioned that “The choice of species for Afforestation should be suggested and the proper sites for the same should be demarcated on the maps.” There is no map in the EMP report’s chapter on Compensatory Afforestation Plan.

Under Greenbelt Plan the scoping clearance asked for “….suitable plant species should be recommended with physical and financial details. A layout map showing the proposed sites for developing the green belt should be prepared.” But the EMP report chapter on greenbelt does not at all comply with it. It makes no mention of any species and no map had been prepared.

The TOR clearance letter under “Reservoir Rim Treatment Plan” asked for “Layout map showing the landslide/ landslip zones should be prepared.” But the maps provided in chapter 17 of the EMP report are not at all clear and the when zoomed in they get blurred. So the sites, even if they exist in the maps cannot at all the located.

The TOR clearance letter under “Muck Disposal Plan” had asked for “The quantity of muck to be generated and the quantity of muck proposed to be utilized should be calculated.” This was not complied with and EMP report in chapter 6 mentioned only about the muck generated from excavation. Under the same, the scoping clearance also asked for “Layout map showing the dumping sites viz – viz other project components should be prepared.” There is no layout map showing the dumping sites.

The TOR clearance letter under “Restoration Plan For Stone Quarries” asked for “Layout map showing quarry sites vis-à-vis other project components should be prepared.” There is no map prepared for complying with this condition.

For “Landscaping and Restoration Plan” TOR letter asked for proper map showing landscaping and restoration site but this was not complied with in the EIA report.

The TOR letter asked the consultant to include a “Certificate” in EIA/EMP report regarding portion of EIA/EMP prepared by them and data provided by other organization (s)/Laboratories including status of approval of such laboratories. The consultant WAPCOS did not comply with this.

Conclusion These are crucial issues which were specifically mentioned in the TOR letter and EIA-EMP not complying with such crucial issues is unacceptable. The public hearing of the project is schedule to be held on 18.01.2014 but going for public hearing without complying with the condition mentioned in the TOR clearance is against the due process of law. The public hearing of Kalai II project should not be held and the EIA should be sent back to the projects developer. Moreover, as pointed out at the outset, the TOR extension given to the project beyond the stipulated period was based on false claim of submission of EIA-EMP that adheres to the TOR. Thus the extension given is invalid and the project must be asked to apply for TOR clearance afresh as per the MoEF norms. The public hearing if conducted on January 18, 2014 in spite of this, will not stand legal scrutiny.

Parag Jyoti Saikia  (meandering1800@gmail.com)

South Asia Network on Dams, Rivers and People (SANDRP)



Arunachal Pradesh

Critique of Kalai II HEP’s Environment Impact Assessment (EIA) Study and Environment Management Plan

The 1200 MW Kalai II HEP located on LohitRiver in Anjaw district of Arunachal Pradesh is being developed by Kalai Power Private Limited (KPPL), which is the Special Purpose Vehicle of Reliance Power Limited. The company had signed the Memorandum of Agreement (MOA) with Govt. of Arunachal Pradesh on 2-Mar-09. The EIA consultant for the project is WAPCOS. The project was recommended for scoping clearance in 31st Meeting of Expert Appraisal Committee (EAC) held on 21-22 October 2009. The project was considered in the 70th EAC meeting on 10-11 Dec 2013 for extension of TOR validity. The advertisement published in Arunachal Times suggests the date as 18th January 2014.

The EIA study cannot clearly state whether Kalai II is a storage project or a run of the river project. The EIA study is also not clear about the height of the dam. Detail analysis of the EIA study reveals that the study is incomplete, inadequate and shoddy. The study cannot qualify to be called an EIA study.

It is also important to note that EIA and EMP reports prepared by WAPCOS have not fulfilled a very large number of the TOR (Terms of Reference) that the project was to cover in EIA-EMP as per the TOR clearance given for the project on 9.12.2009. Such EIA-EMP will clearly not be acceptable even from statutory and legal point of view and cannot be basis for a public hearing. A report on the status of compliance with TOR in EIA and EMP is available here – https://sandrp.wordpress.com/2014/01/15/eia-emp-of-kalai-ii-hydropower-project-doesnt-comply-with-its-terms-of-reference/. Arunachal Pradesh State Pollution Control Board (APSPCB) and MoEF should immediately cancel the public hearing and ask the EIA-EMP consultants to comply with the TOR first. A letter sent to APSPCB in this regard can be found here – https://sandrp.wordpress.com/2014/01/15/letter-to-apspcb-public-hearing-for-kalai-ii-hep-to-be-held-violating-the-norms/.

Issues Related with EIA consultant WAPCOS

Cumulative Impacts Assessment Study of Lohit Basin Prepared by WAPCOS is Farce The local people from Lohit basin have categorically stated that the cumulative impact assessment study done for the Lohit basin by WAPCOS is farce. In a news published in Arunachal Times (available in Annexure I) people have stated “Water and Power Consultancy Services (WAPCOS) had earlier conducted a cumulative impact assessment of various hydropower projects in the entire Lohit river basin, as per the directives of MoEF. WAPCOS made a farce report, completing within 2-3 weeks. The study is very poor and shoddy…..” Now for the Kalai II project the same organization is preparing the EIA report. From the track record of WAPCOS and from the experiences of the people in the Lohit basin, it is clear that an EIA prepared by WAPCOS cannot at be accepted as a complete, unbiased study.

People of Lohit Basin will not Accept Studies done by WAPCOS It is important to note that people of Lohit basin have already expressed their anger and disbelief on studies done by WAPCOS. In a letter written to the Union Minister on Environment and Forests on 15 march 2012 the, Peoples Forum For Project Affected Family (PFPAF) had clearly stated the following “….no study of WAPCOS would be acceptable to the people of the Lohit Valley and other social and environment conscious people for two main reasons. Firstly, WAPCOS is an organisation under the Union Water Resources Ministry, and Union Water Resources Ministry is basically a pro dam lobby. WAPCOS also does other pro dam studies like the feasibility reports and Detailed Project Reports for Big dams, such studies are done in favour of Big dams and an organisation that is doing such business cannot be entrusted to do an environment or cumulative impact assessment study. Secondly, WAPCOS also has had very poor track record and has done very poor quality EIA and CIA reports. Hence, in future, we will not accept any reports done by such organisations.”

It is important to note that when the people of the whole Lohit basin had raised objections against WAPCOS, the government and companies should not have hired WAPCOS the project consultant. This indicates a hidden strategy on the part of the project authorities to employ only pro-dam EIA consultants to get favourable outcomes.

Location of Kalai II HEP. Source: EIA report
Location of Kalai II HEP. Source: EIA report

Critique of the Kalai II EIA study

Biased EIA An EIA report should be an unbiased assessment of impacts of the project. The EIA report of Kalai II HEP is a biased towards hydropower, as can be seen from what has been written in section 1.3, page 1-3: “In Arunachal Pradesh so far a capacity of 423.5 MW has been developed which is just 0.84 % of the total potential. Hydro projects of about 2600 MW are being constructed which is about 5.17 % of the total potential. It is evident from the above that the capacity developed and under development will be achieved for 3023.5 MW in very near future, still leaving behind a potential of about 47304.5 MW (93.99%).” This shows clear towards hydropower project and this EIA report of Kalai II HEP prepared by WAPCOS cannot be considered a neutral assessment of impacts of the project.

EIA does not mention Maximum Water Level of the reservoir The EIA study does not mention the Maximum Water Level of the reservoir when the dam passes peak flood. It only mentions the FRL as 904.80 m.

Large Submergence Area The area which Kalai II project will submerge is very large considering that it is RoR project. The EIA document in Section 6.4 mentioned “The construction of a 198 m high concrete gravity dam shall create a reservoir of area approx. 640 Ha at FRL of El.904.8m. The reservoir will extend up to 15 km along the river Lohit. The reservoir width shall range from about 600 m to 1000 m over most of its length.” But news report published Arunachal Times states that submergence route extends upto 23 km upstream. The report also stated that the project will submerge the entire Hawai circle and all the major villages directly affecting 1500 people.

It is important to note here is that size of the total area required, the number of affected villages and population mentioned in this EIA is much higher than the numbers mentioned for the project when it was considered for TOR clearance in EAC on 21.10.2009. The minutes of that EAC for Kalai II stated that Total land requirement is 830 ha, which has now grown by 32.5% to 1100 ha (Section 2.2 of EIA), No of affected villages has grown from four villages to 25 (525% increase), No of PAFs has grown from 22 to 595 (2605% increase) and no of affected people has grown from 122 to 2279 (1768% increase). This means that the impacts were grossly understated at scoping stage. Is such gross and deliberate understatement acceptable?

Huge land requirement not justified The project claims to require 1100 ha of land, 370 ha more than the land requirement of 830 ha stated at the time of scoping. This land demand seems unjustified and inflated and cannot be accepted at face value. The EIA does not even attempt to look into this issue.

EIA under estimates the number of affected population Even though the EIA has stated 595 as PAFs it still seems a hugely under stated number of affected families. The report claims that their survey team contacted a total of 595 PAFs where the total population of the project affected area is stated as 2279. But the detailed news report of Arunachal Times says that the project will submerge the entire Hawai circle and all the major villages. If this is true then the project will affect much larger no of people.

It is also relevant to note that even as the Kalai II project will affect 595 families (according to the EIA) in order to generate electricity, 565 families or 91.6% project affected families already have electricity supply. (EIA report page 9-13)

Submergence of the existing national highway: Impacts of alternative road not assessed The reservoir of Kalai II HEP will submerge 16 km of existing national highway. The border roads organization will construct two lane road at a higher elevation in place of this. The construction of this alternative road will imply land use, more social impacts, more blasting and other construction related activities, but these impacts have not been included in the EIA.

The alternative highway is planned to be constructed at elevation 910 m. However, since MWL is not given and also backwater effect, which will be higher than MWL at times of peak flood, it is not clear if the alternative elevation would be affected by back water effect.

Many Maps are not readable The project layout map at Figure-2.1 is not legible. The map is very small and except title none of the other details or legends are legible. The EIA must provide a detailed layout map for the Kalai II HEP. The same is case with Geological Plan of Reservoir Area map (Fig 6.1 and 6.2) which are two very important maps but they are not at all legible.

In most places the project consultant have used unclear maps. e.g. ‘Fig 7.7 – Water Sampling location map’ or ‘Fig 8.1 Terrestrial Ecological sampling location map’. An EIA with such illegible maps cannot be acceptable.

Impacts on Migratory Fish Construction of Kalai HEP II will have devastating impacts on fish in the river. The path of the migratory fish will be blocked and this has been accepted by the EIA as well – “The dam construction activities will also create a problem for migratory fish species (Tor tor and Tor putitora).” (Page 8-38). The two species of Mahseer, Tor tor and Tor putitora, locally known as Ngorika and Ngauch respectively and have been listed as ‘endangered’ in IUCN list. But it is surprising to see that EIA opining that “These migratory fish species may move into the small tributaries of LohitRiver.” It is no clear what is the basis of this statement by WAPCOS, it does not seem to show sufficient ecological literacy. The EIA prepared by WAPCOS also seem to ignore that several dams have been proposed in the tributaries as well. The EIA also does not say how well the area has been studied and what kind of biodiversity we may be losing.

Wrong claims about reservoir water quality The EIA says about reservoir water quality, “The proposed project is envisaged as a runoff the river scheme, with significant diurnal variations in reservoir water level. In such a scenario, significant re-aeration from natural atmosphere takes place, which maintains Dissolved Oxygen in the water body. Thus, in the proposed project, no significant reduction in D.O. level in reservoir water is anticipated.” This conclusion is clearly wrong. The EIA says about the reservoir: “The Gross and diurnal Storage of the Kalai-II reservoir are 318.8 M cum and 29.76 M cum with FRL at El 904.80 m and MDDL at El 900.00 m respectively”. This means that 93.35% of the reservoir is dead storage and only 6.65% of the reservoir capacity acts as live storage. Such a large quantity of dead storage will have huge impact on the water quality and the claim to the otherwise by the EIA is clearly wrong and misleading. Similarly the EIA claim of no Eutrophication risk due to “significant diurnal variations in reservoir water level” is clearly wrong.

No Options Assessment The EIA of Kalai II HEP does not do any options assessment. The EIA religiously focuses on the construction of 1200 MW project without mentioning the fact that successful sub-megawatt capacity hydropower projects (Less than 1 MW) are operational in Anjaw district (see Annexure II).

Conversion of community land into forest land can have negative impacts on the communities The EIA on page 10-25 states, “The total land requirement for the project, is 1100 ha. The entire land is considered as forest land. A part of the community land also includes forest land as well. For EMP purposes, the entire quantity of land has been considered as the forest land.” This can lead to severe impacts on the communities.

Here it is important note the implications of actions of similar nature on the Meyor community in the Kithibo area of Anjaw district, in the upstream of Kalai II HEP. A news published by Asian Human Rights Commission (see Annexure III) reports, “The Asian Human Rights Commission (AHRC) has received information from civil society groups regarding death threats, arbitrary detention and harassment of members of the Meyor community, a group of indigenous people in Arunachal Pradesh. They are being targeted for their activities on conservation of community land and natural resources.” The leaders of the community reported to have “protested the conversion of the community forest land of Walong and Kibitho area into reserved forest land because it was carried out without the free, prior and informed consent of the Meyor community.” It is important to note that this report also mentioned about impact of dams and other development activities on tribal ethnic communities. However, the EIA is silent on these aspects.

Cumulative impact migrant population in Lohit valley can be catastrophic The Kalai II project EIA states that the maximum number of people coming from outside the region for construction will be 3000 and the impacts are predicted to be only in the construction phase. Here it is important note that the number of outside workers provided by EIAs have proved to be gross under-estimates. But the EIA here does not mention anything about the cumulative impacts of migrant population for other projects along with Kalai II. In fact in a letter written to the Minister of Environment and Forests by the PFPAF, it was mentioned that the whole area of Lohit valley is inhabited by tribal population. The total tribal population as according to 2011 census is 16500. The cumulative number of migrant workers will clearly surpass this population figure, leading to severe impacts on the people of the area.

Lohit river in Anjaw district.  Source: EIA report
Lohit river in Anjaw district.
Source: EIA report

Disaster Management Plans do not mention about seismic risks Discussing the disaster management plan for the dam, the EIA study mentions only few issues and ignores the issue of earthquakes: “However, in the eventuality of dam failures in rare conditions, catastrophic condition of flooding may occur in the downstream area resulting in huge loss to human life and property. Floods resulting from the failure of constructed dams have also produced some of the most devastating disasters of the last two centuries. Major causes of failures identified by Costa are overtopping due to inadequate spillway capacity (34 percent), foundation defects (30 percent), and piping and seepage (28 percent).”

The EIA does not include the following important assessments:

a. Assessment of impacts of quarrying on the river bed and river banks The Kalai II project will require 72.6 lac cumec boulders for construction of the project and all of these will be extracted from the river bed and river banks.

Even though the EIA itself mentions how the removing of boulders and gravel from the river bed will affect spawning areas of fishes (page 10-29), but does not suggest for any detail impacts assessment. It limits itself by stating about adequate precautions during dredging period. But it is highly doubtful that any of those precautions will be followed when actual dredging will be done to extract lakh cumecs of construction material when there are no specific steps or mechanisms suggested. Without full assessment and management plan, the EIA cannot be considered adequate.

b. Assessment of impacts of blasting for tunneling and other works in the pristine and fragile hill range – Blasting in the fragile hill ranges of Arunachal can have severe impacts, especially in increasing the probability of landslides. In Such circumstances, the EIA stating that no major impacts of blasting are envisaged at the ground level is wrong and puts a big question mark on the EIA.

c. Impact of the project on disaster potential of the area has not been assessed.

d. Impacts of peaking power operation on hydrological regime, biodiversity, and life & livelihoods of people

e. Impact of flushing out of silt from the reservoir

f. Impacts of climate change on the project and project’s impacts on local climate

g. There is no assessment of the value of the river that will be destroyed by submergence in the upstream and drying up and changed hydrology in the downstream.

h. The EIA has not properly assessed the downstream impacts of the project. It may be recalled that the ongoing massive agitation in Assam against such impacts of the under construction 2000 MW Lower Subansiri HEP, that has led to stoppage of work there since Dec 2011 is focused on downstream impacts and this project will face the same fate if this is not attended to.

i. No public consultations in Assam Linked to the above issue is the need for public consultations in downstream Assam about this and all other Lohit basin projects, without which there will be no question of public acceptability of the project and the project may face the same fate as that of Lower Subansiri HEP.

Doubtful, contradictory and sweeping statements in EIA The EIA at several places have stated made such statements:

Page 10 -23, para 4: “The construction of the dam would form the reservoir which will submerge about 640 ha of area in upstream. The area witnessed jhum/shift cultivation practiced by local inhabitants. Submergence of the area would not impact much on the prevailing land use pattern.”

This is clearly wrong, since jhum cultivation is one of the key livelihood supporting activity in these areas and if such land is submerged, it will have major impacts on the land use pattern.

Page 10 – 30, para 3: “As a result, barring for monsoon season, (May to September), the river Lohit will have dry periods for few hours for generation of peaking power.”

The idea of ‘few hours’ a complete misnomer and misleading, it will happen daily for 15-20 hours. In the analysis of Lohit basin study SANDRP had found that for Kalai II, “In lean season river water will be stored for a period of 15-20 hours. As a result, downstream stretch of river from the dam site will remain dry for that period. This will be followed by a continuous flow of 1112.27 cumecs (rated discharge) for a period of 4 to 9 hours.” (Lohit Basin Study by WAPCOS: A mockery of e-flows and cumulative impacts – https://sandrp.in/rivers/Lohit_Basin_Study_by_WAPCOS_A_mockery_of_e-flows_and_cumulative_impacts.pdf)

Parag Jyoti Saikia (meandering1800@gmail.com)

with inputs from Himanshu Thakkar

——————————————————————————-

Annexure I

Villagers block road demanding scrapping of Kalai II dam

Link : http://www.arunachaltimes.in/wordpress/2012/06/06/villagers-block-road-demanding-scrapping-of-kalai-ii-dam/

Raju Mimi

HAWAI, Jun 05: About 500 villagers of Hawai circle on Monday staged a dawn-to-dusk road blockade at Walong-Hawai road demanding scrapping of the 1200 MW Kalai II dam proposed on LohitRiver.

The villagers protested under the banner of Peoples Forum for Project Affected Families (PFPAF). Road communication at Hawai was totally disrupted for the whole day affecting even the movement of military vehicles.

Talking over telephone from Hawai, PFPAF Chairperson Behenso Pul said: We had earlier submitted memorandum demanding scrapping of Kalai II dam to Union Ministry of Forest and Environment, chief minister, local representatives putting our grievances. But no one is listening to us. So we decided to launch our democratic movement.

The villagers staging protest demanded for permanent halt of property survey, and other survey and investigation being carried out for the hydro electric project. A memorandum was submitted to deputy commissioner, Hawai placing all grievances and the demands.

We are highly encouraged by the massive participation of villagers in such short notice. It is a great moral boost for people working against dam, said Pul. But there was no participation from panchayat leaders, students union and other civil society organization.

The Kalai II Hydro Electric Project is to be developed by one of the major Reliance Power subsidiary, Kalai Power Private Limited (KPPL). It was incorporated on September 26, 2007. The project site is in LohitRiver in Kumblung and the submergence route extends upto 23 km upstream.

The project involves construction of 161 meter high concrete dam. An underground power house will be constructed to house 8 units of 150 MW turbines. The total project cost is estimated at Rs. 69,551 million and is likely to be completed in 7 years time.

The Kalai II project will lead to submergence of entire Hawai circle and all the major villages. Around 1500 people are being directly affected by the dam, said Pul. Since last week, we carried out grassroots campaign on dams. We haven’t met one single person who is in favour of dam. Everyone one is scared and against it. In Anjaw district alone, at least 6 large dams are proposed within 150 km of river route out of 13 projects in the entire Lohit basin. Water and Power Consultancy Services (WAPCOS) had earlier conducted a cumulative impact assessment of various hydropower projects in the entire Lohit river basin, as per the directives of MoEF.

WAPCOS made a farce report, completing within 2-3 weeks. The study is very poor and shoddy, said Pul.

According to PFPAF, they are, however, not opposed to all dams in Anjaw district. They view that projects along the tributaries of Lohit river can be harnessed, instead of building large dams along the main river alone. Citing a report in a national news magazine, Pul said the tributaries of Lohit alone had capacity to produce 8000 MW.

Out of the 7 circles in Anjaw district, 5 are situated along the main Lohit river. Even Hawai headquarter is in the bank of Lohit river. So, if dams are built along the main river, majority of the 18000 Mishmi population will be affected, said Pul.

In April 13 meeting with Chief Minister Nabam Tuki at Tezu, the PFPAF had suggested the government to consider harnessing power in the tributaries of Lohit river, not in the main river, where majority of population live. It is learnt that chief minster had made assurance of stopping all dams wherever not required.

If small dams are built in the tributaries, which are in the interior places, people there can benefit in the form of roads and other developments,Pul said.

———————————————————

Annexure II

Anjaw shines in hydro power sector

Link : http://articles.timesofindia.indiatimes.com/2012-01-02/guwahati/30580969_1_hydropower-projects-hydel-project-power-supply

TNN Jan 2, 2012, 05.50AM IST

ITANAGAR: The remote Anjaw district of Arunachal Pradesh is marching ahead to notch a record in the hydropower sector and is being hailed as the future powerhouse of the country with a 58,000 MW hydropower potential.

Kaho, a village in the district located near Kibithoo along the tri-junction of the China-Myanmar-India border, had created a record in 2007 by becoming the first village in the state to have round-the-clock power supply besides supplying power to the Army personnel guarding the frontier.

This feat was achieved thanks to the determination of the lone elected representative of the district, Kalikho Pul, and the equally committed deputy commissioner, Prashant S Lokhande. The two officials were instrumental in commissioning a micro hydel project in the last border village, a 24-hour trek away from last pitch road, for which all the machines and material had to be transported manually.

The duo’s efforts in turning the odds to their advantage made Anjaw the first of the 17 districts in the state to commission many of the ongoing projects.

Pul, who toured the district and inspected all the project sites recently, said the 2X100 KW Yapak, 2X50 KW Khrowtipani, 2X250 KW Matinala and 2X250 KW Teepani projects were commissioned recently and made the border district self-sufficient in power.

At the moment, Hawai, Hayuliang, Goiliang, Manchal, Walong, Kibithoo and Metengliang administrative centres and adjoining villages are getting 24-hour uninterrupted power supply, Pul said, adding that various development activities would begin now with availability of power, thereby boosting the local economy as well.

Located along the Sino-India border, the district is spread across an area of 9,936 sq km and crisscrossed by numerous perennial rivers, including Lohit, Dav, Dalai, Lati, Kulong, Syang, Helei, Yapak and Kathang, has total hydropower potential of above 7,000 MW.

The projects – 2X50 KW Hatipani at Goiliang, 2X30 KW Ashapani, 2X100 KW Kachopani, 2X30 KW Maipani and 2X200 MW Langpani at Gamliang – are likely to be commissioned within a month or two, Pul informed.

He added despite the locational and other disadvantages, the projects could register speedy growth because of proper utilization of funds and strict monitoring.

The hydropower projects were taken up with the vision to benefit the locals as well as the state in general, he said, adding the 16 MW Haleipani project, which is at an advanced stage, is likely to be commissioned within 2012. “It will cater to the needs of Lohit, Dibang and Changlang districts besides meeting the requirements of Anjaw,” he added.

However, according to official sources, no steps have been initiated so far for erecting transmission lines for evacuation of excess power to be generated by the Haleipan project. Once the transmission lines are commissioned the state would be almost self-sufficient and would not need to purchase power at high prices from outside.

Pul added as the Haleipani project is on the verge of completion, the state government, particularly the hydropower department, should take up the transmission line project proposed in Anjaw. The project is pending with the department for the last many years. Without the transmission lines, any quantity of power generated would be futile as it cannot be utilized for any purpose, he said.

Kaho, a village in the district located near Kibithoo along the tri-junction of the China-Myanmar-India border, had created a record in 2007 by becoming the first village in the state to have round-the-clock power supply

——————————————————————–

Annexure III

INDIA: Violent Attack, Arbitrary Detention, Death Threats to activists of Meyor Community, Arunachal Pradesh

Link: http://www.humanrights.asia/news/urgent-appeals/AHRC-UAC-152-2013

ASIAN HUMAN RIGHTS COMMISSION – URGENT APPEALS PROGRAMME: Urgent Appeal Case: AHRC-UAC-152-2013

9 December 2013

—————————————————————————————

INDIA: Violent Attack, Arbitrary Detention, Death Threats to activists of Meyor Community, Arunachal Pradesh

ISSUES: Arbitrary detention, freedom of speech and expression, indigenous people’s rights, protection of environment, land rights, human rights defenders

—————————————————————————————

Dear friends,

The Asian Human Rights Commission (AHRC) has received information from civil society groups regarding death threats, arbitrary detention and harassment of members of the Meyor community, a group of indigenous people in Arunachal Pradesh. They are being targeted for their activities on conservation of community land and natural resources. The Meyor community with about 450 members is classified as one of the Scheduled Tribes under the Indian Constitution and is mostly confined to the Anjaw district of the state. They have been criticized for opposing government activities that includes conversion of community land to reserved forest land and corruption in the Public Distribution System (PDS).

CASE NARRATIVE Several representatives of the community assumed a leadership role. They are, namely:

Mr. Chung Meyor, 33, Dhanbari village

Mr.Chaping Meyor, 55, Gaon Bura (village chief), Khroati village

Mr. Unchen Meyor, 45, Barakhundun village

Mr. Chethel Meyor, 25, Dhanbari village

Mr. Tharpa Meyor, 26, Musai village

Mr. Tenzing Dorjee Meyor, 30, Sotakhundun village

Mr. Fendey Meyor, 30, Musai village of Arunachal Pradesh

These men protested the conversion of the community forest land of Walong and Kibitho area into reserved forest land because it was carried out without the free, prior and informed consent of the Meyor community.

The conversion of community land into forest land was initiated, allegedly, by Mr. Kalikho Pul, a member of the Arunachal Pradesh Legislative Assembly. He allegedly collected signatures from the Meyor community under the pretext of development works in the area. Conversion of this forest area was completed in 1995-1996 with a proposal of afforestation. Through an application, under the Right to Information Act, 2005 filed by Mr Dimso Manyu of the Meyor community, the people came to know of this development only on 14 March 2012.

The villages of the Meyor community are within a 36 square kilometer perimeter and their livelihood is dependent on natural resources. Over a period of time they faced limited access to the land resources due to the conversion of community land into ‘forest land’. Once they came to know of the conversion, the community vehemently opposed it. Due to their opposition, it is alleged that the police and unknown trouble-makers carried out frequent detentions, arrests, tortures and intimidations of community leaders and representatives of the Meyor tribe.

On 26 April 2013, armed reprobates arrived in a white Scorpio Jeep, threatened and attempted to torture Mr. Chung Meyor near Naraliang village on Tezu-Hayuliang Road. On the same day, Mr. Chung lodged a complaint about the incident at the Khupa police station. Police have not taken any action so far.

On 1 June 2013, Mr. Unchen Meyor filed a complaint at the Khupa Police Station. He cited mismanagement, corruption and illegal activities committed at a Fair Price Shop set up under the government’s Public Distribution System. Incidentally, on 12 November 2013 some local youths discovered that Mr. Agam Rai was selling PDS items illegally to people who were not subscribed under the PDS system. In connection to this discovery, a counter- police complaint was lodged by Mr.Kayawlum Tawsik, Chairperson, Zilla Parishad (local government), Anjaw Disttrict, against Mr. Unchen Meyor, Mr. Chethel Meyor and Mr. Tharpa Meyor.

On the night of 13 November 2013, Mr. Unchen and his family were brutally assaulted by a group of criminals at his residence in Barakhundun village. Mr. Unchen is still in critical condition due to injuries to his head, nose and chest. His daughter made a complaint about the attack on 15 November to the Khupa police station. However, till now, the police have not taken any action.

A second time, on 28 November 2013, Mr. Fendey Meyor, member of Gram Panchayat (local government) was arrested by the police from his village, Musai. They demanded the immediate surrender of Mr. Unchen, Mr. Chethen, Mr.Tenjing at the Khupa police. Mr. Fendey was released on 3 December on bail, with fabricated charges of vandalising still pending. Mr. Unchen is in hospital (at Aditya Diagnostic, Diburgar) struggling for his life. Mr. Chethen and Mr. Tenjing are in hiding, fearing for their lives and personal security. Similarly other community activists like Mr. Chung Meyor, Mr. Chaping Meyor and Mr. Tharpa Meyor are equally exposed to threats to their lives.

ADDITIONAL INFORMATION Arunachal Pradesh, bordering on China, is one of the most thinly populated states in India. It has 101 recognized indigenous tribal groups and about 50 languages. There are several rivers with the potential for generating hydro-electric power. The government has planned to construct some 168 mega-dams in the state, a move opposed by the indigenous people living there. There is a heavily militarized presence due to the international border. Draconian measures under the Armed Forces Special Powers Act, 1958 (AFSPA) is applicable in two districts of Arunachal Pradesh, namely Tirap and Changlang, and a 20 kilometer area bordering Assam.

SUGGESTED ACTION:

1.            Urge the Government Authorities of India and the State Government of Arunachal Pradesh to guarantee the physical and psychological security of the members of the Meyor Community and its leaders.

2.            Urge the authorities to protect the indigenous people’s right to land and resources.

3.            Urge the authorities to protect the environment and not to grant deforestation rights.

The AHRC is writing a separate letter to the UN Special Rapporteur on the Rights of Indigenous People and the UN Special Rapporteur on Protection of Human Rights Defenders for immediate intervention in this matter.

——-ooo——-
